A gravel driveway lives or dies on what is under it: a compacted crushed rock base, a fall that sends the water off, and a top layer that is rolled rather than raked. We dig, base and finish gravel and crushed rock driveways across the Yarra Valley and the hills, and if yours only needs a resurface, we’ll say so.

Most gravel driveways that go to ruts and potholes have failed underneath, not on top. Topsoil left in, a soft spot nobody dug out, or rock that was tipped and spread instead of compacted, and the surface follows it down within a couple of wet seasons.
So the order on our jobs doesn’t change. Topsoil and soft ground come out first. The ground underneath gets compacted. Crushed rock goes down as the base and gets rolled in its own layer, and the fall goes into that base, not into the last few millimetres of topping. Water has to leave the surface across its width and along its length, and end up somewhere it’s allowed to go.
Plenty of ground through the valley and the hills holds water for weeks after rain, and ground that’s wet when it gets compacted doesn’t stay compacted. We’d rather wait out a wet week than roll a base into mud.
There’s no single best driveway rock. It comes down to what’s underneath and what the driveway has to carry. These are the ones we’ve laid on real jobs around the valley.
Coldstream crushed rock is the workhorse. It goes down as the compacted base, and on plenty of rural tracks it’s the finished surface too.
Mansfield toppings are the finer gold layer that goes over a crushed rock base when you want it looking finished around the house. The fine dust in the mix is what holds toppings together, so they bind best rolled damp, not bone dry. Natural toppings also vary from load to load, so a top up years later won’t always match exactly.
Class 4 is the economical grade. The VicRoads crushed rock specification that councils build roads to lists it as a lower subbase, the layer under the good stuff. Rolled over a driveway that already has a sound base, it makes a hard top for a lot less than starting again. That’s what we did in Olinda.
Recycled asphalt profilings are old road surface, milled up. Compacted, they bind into a firm, dark surface that suits shed pads and working areas where machinery comes and goes, like our Monbulk job below.
Going with pavers or concrete instead? We dig and prepare the base to suit and work with your paver or concretor, so what they lay isn’t sitting on ground that’s going to move.

If the surface has worn thin or gone to potholes but the driveway still feels firm underfoot and sheds water, a resurface is usually enough. If the ruts come back in the same place after every top up, or it goes soft and holds water after rain, the base has gone, and more rock on top just buys you a season.
The quick test is to walk it the day after heavy rain. Puddles in the wheel tracks and spongy patches point to the base. Loose gravel at the edges and potholes on an otherwise firm surface point to the top. Water running straight down the middle and taking the fines with it points to the fall, and that gets fixed at base level, not with a heavier rock.
Starting again means digging the old surface out, fixing the ground and the fall, and building it back up in layers. If there’s an old concrete or asphalt driveway in the way, breaking it out and carting it off happens on the same visit, and broken concrete goes to a recycler to be crushed and reused rather than to landfill. We’ll tell you which one you’ve got, including when the honest answer is a top up.
The Bureau of Meteorology outlook issued on 5 November 2026 has summer maximums very likely above average across Victoria, with eastern Victoria among the areas most likely to see unusually hot days. For rainfall it shows no clear signal either way over most of the state.
For a gravel driveway that cuts both ways. Dry ground is the best time to compact a base. A toppings surface, though, dries out and loosens where cars turn, and one summer storm on a driveway with no proper fall carries the fines straight down the hill. On a long rural run, fire season is also when the CFA access rules in the questions below start to matter: width, clearance overhead, and somewhere for a truck to turn.
The right driveway surface depends on what is already on your block and what the driveway has to carry. Here are three of ours from around the valley and the hills, each finished differently: toppings over crushed rock in Coldstream, recycled asphalt profilings in Monbulk, and a straight Class 4 resurface in Olinda.
Spring is a good time to look hard at yours. After a hills winter it is easy to see where the water ran and which parts of the surface went with it.

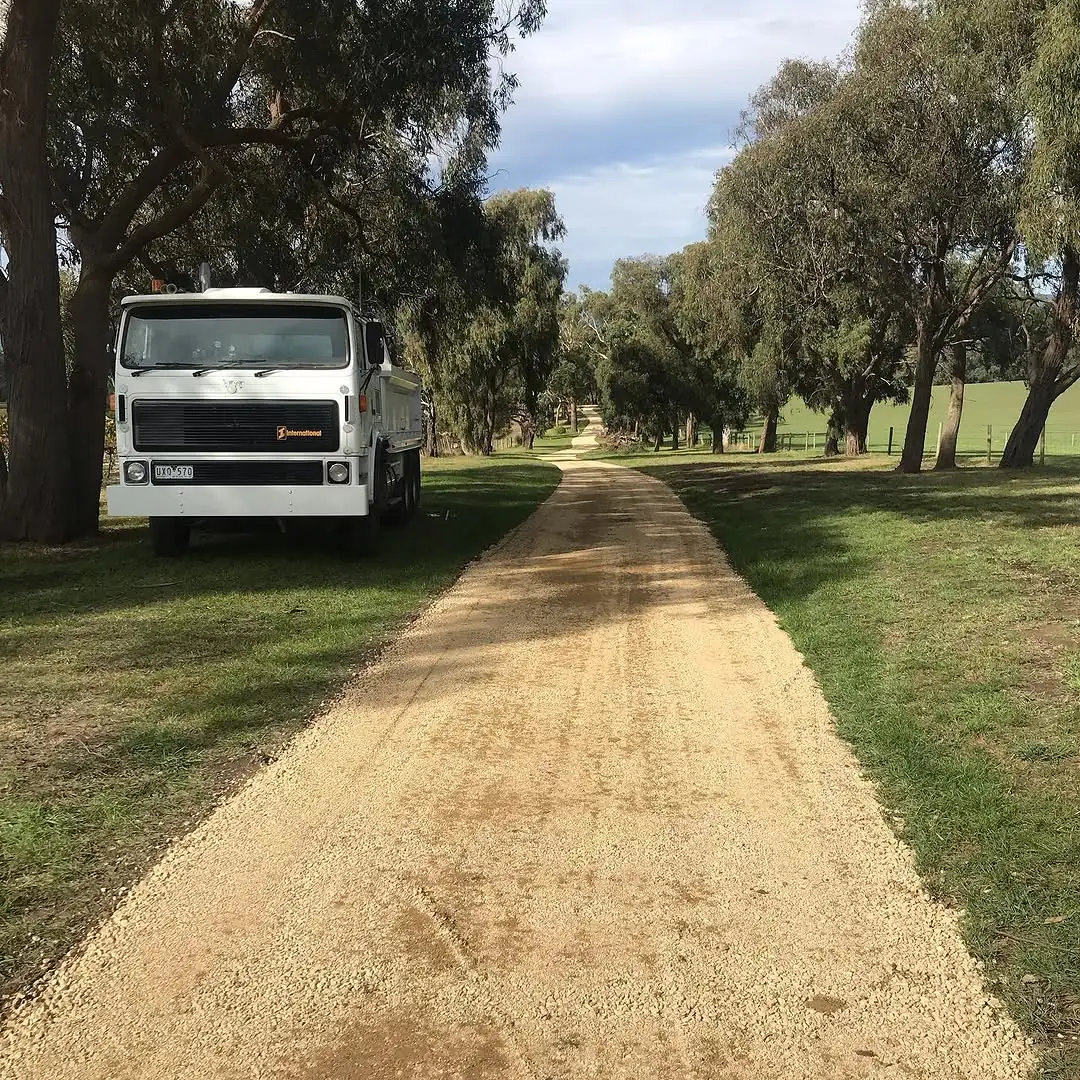

2,000 square metres of driveway in Coldstream, done in Mansfield toppings and Coldstream crushed rock. It came up an absolute treat.

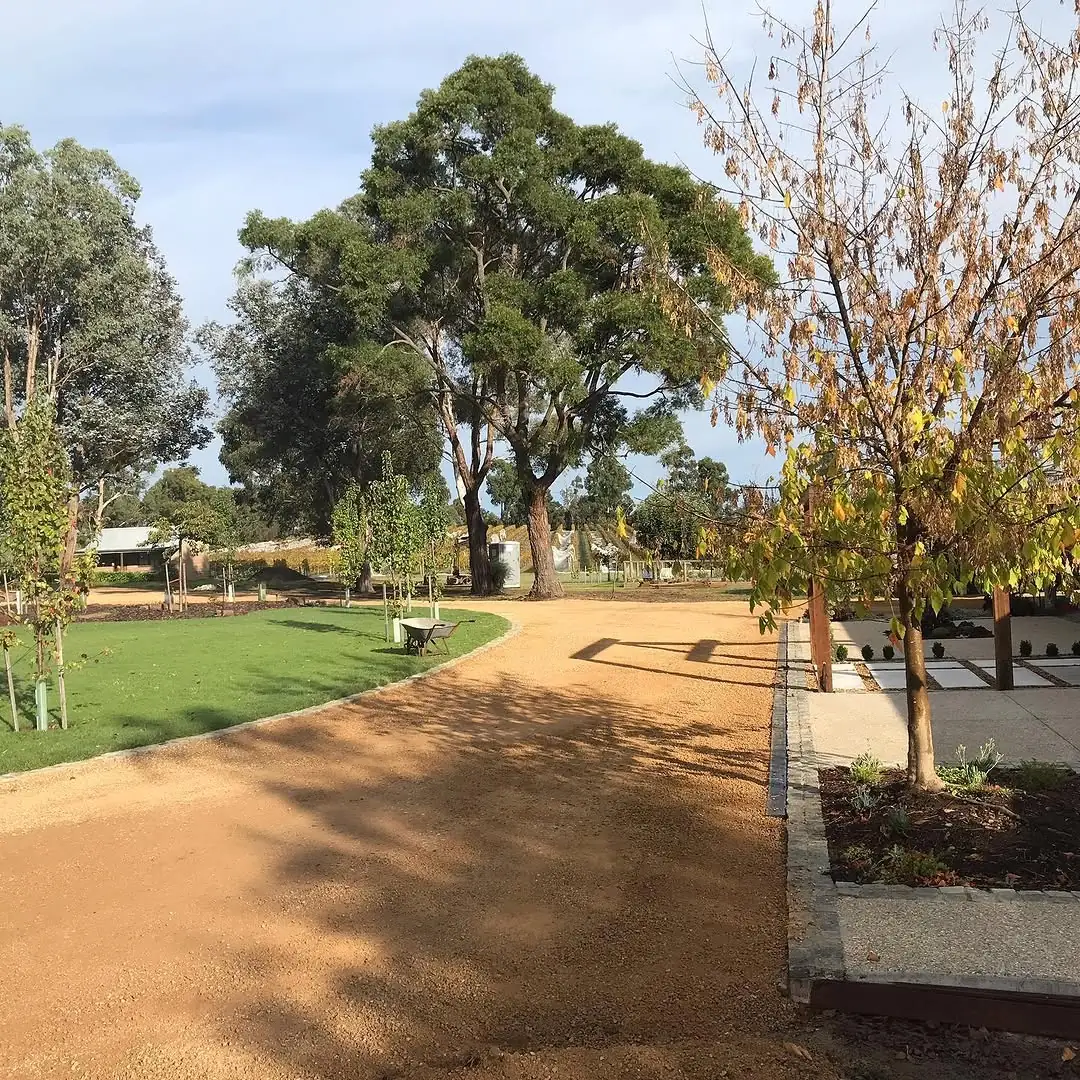

That combination is the classic two-layer gravel driveway, and the order matters. The crushed rock goes down first as the base and gets compacted on its own. The toppings go over it as the finer wearing layer and get compacted separately. What holds a toppings surface together is the fine dust in the mix, so it has to be rolled, not just spread and raked, or it stays loose and ends up on your boots and in your garage.

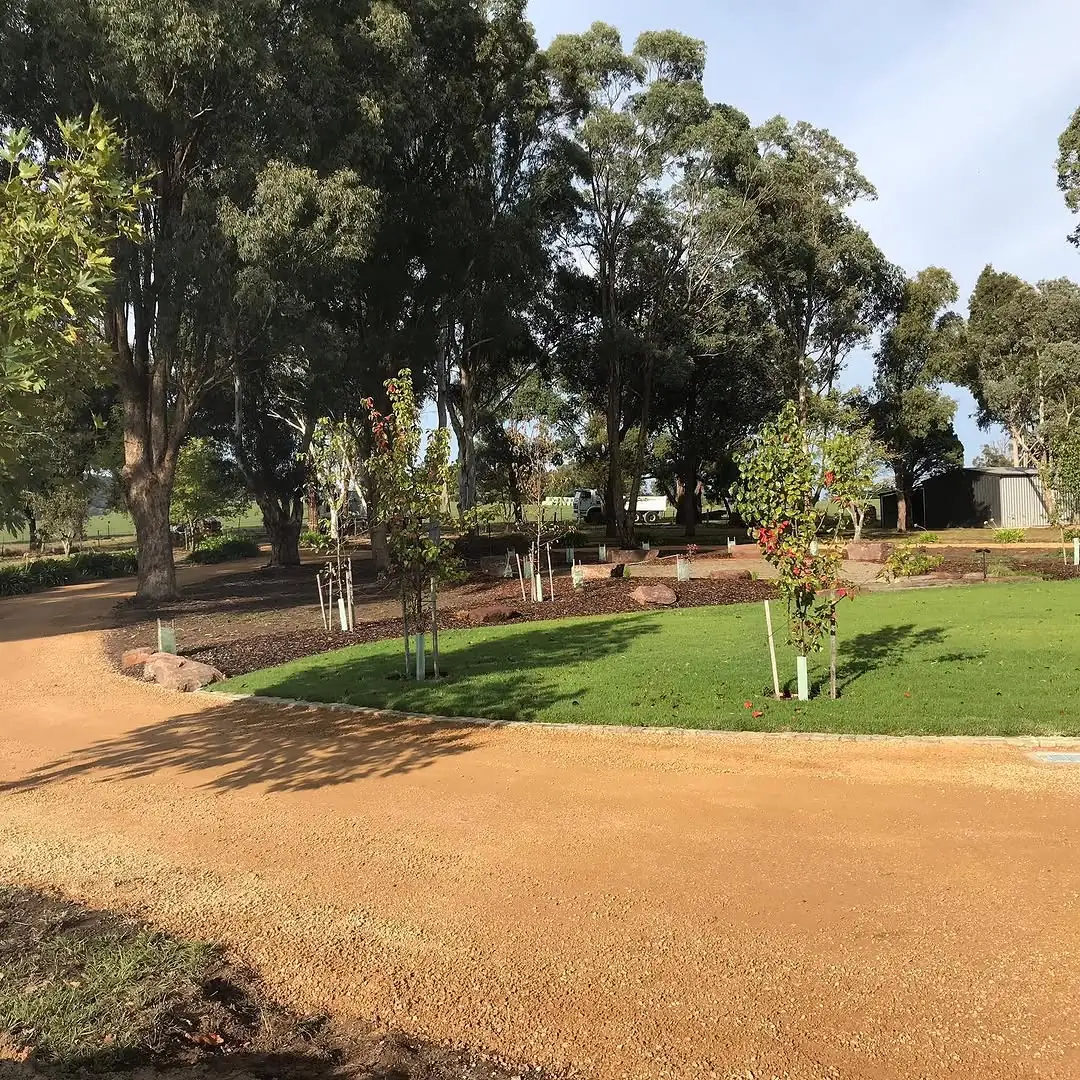

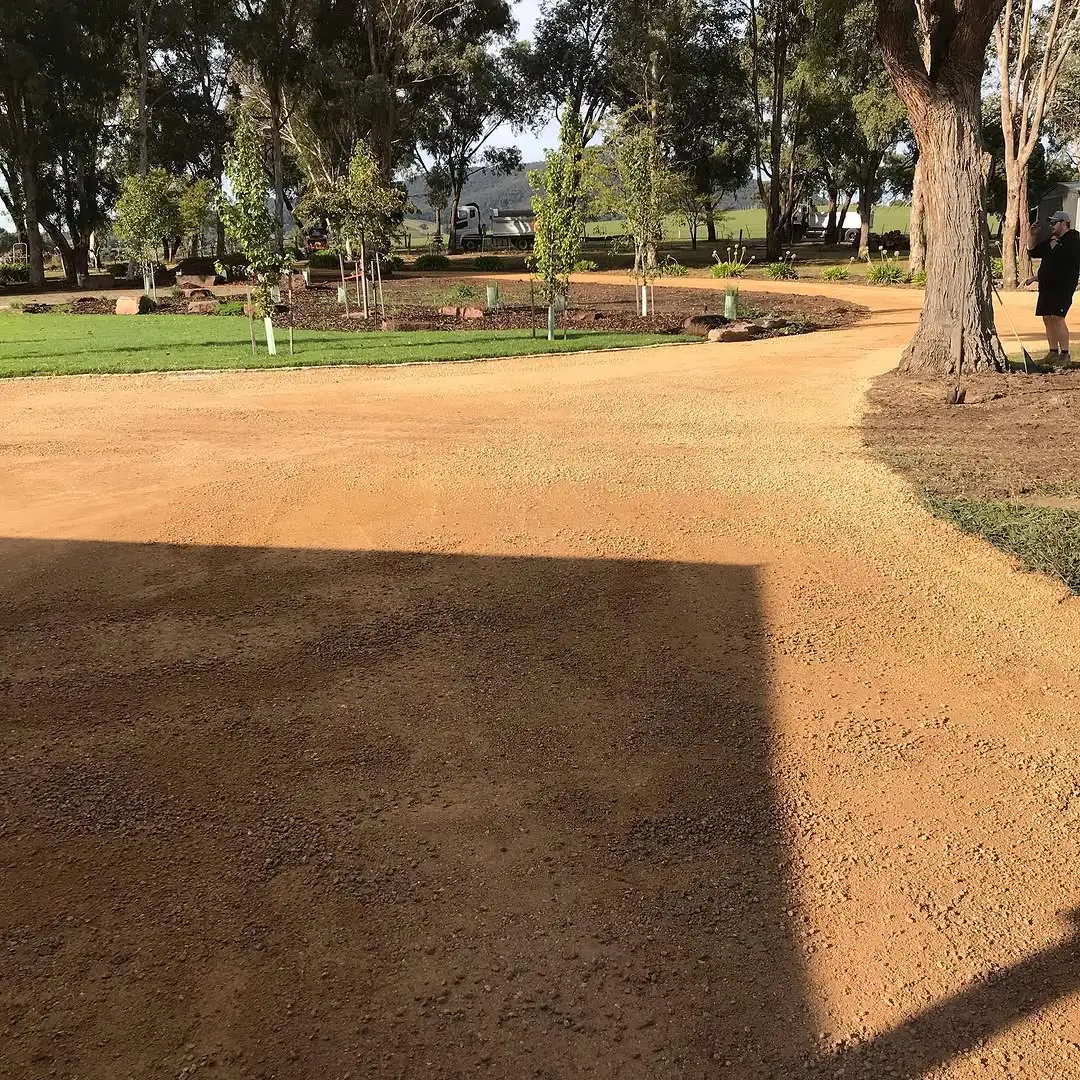

On a run this size the shape is half the job. This one sweeps around lawn and garden beds rather than cutting straight through, and the curves and edges have to be right before the topping goes on, because that is what makes it look finished rather than tipped.
That same May we were back in Coldstream for a site cut and pool excavation, with 130 cubic metres out the gate.
A driveway cut and a shed pad on the same block in Monbulk, with two loads of recycled asphalt profilings brought in.
Profilings are what comes off a road when the old asphalt is milled up before it gets resurfaced. Spread out and compacted properly they bind back into a firm, dark surface that holds up to traffic and sheds water, for a fraction of what fresh asphalt or concrete would cost. That makes them a good fit for working areas around a shed, where vehicles and machinery are coming and going.

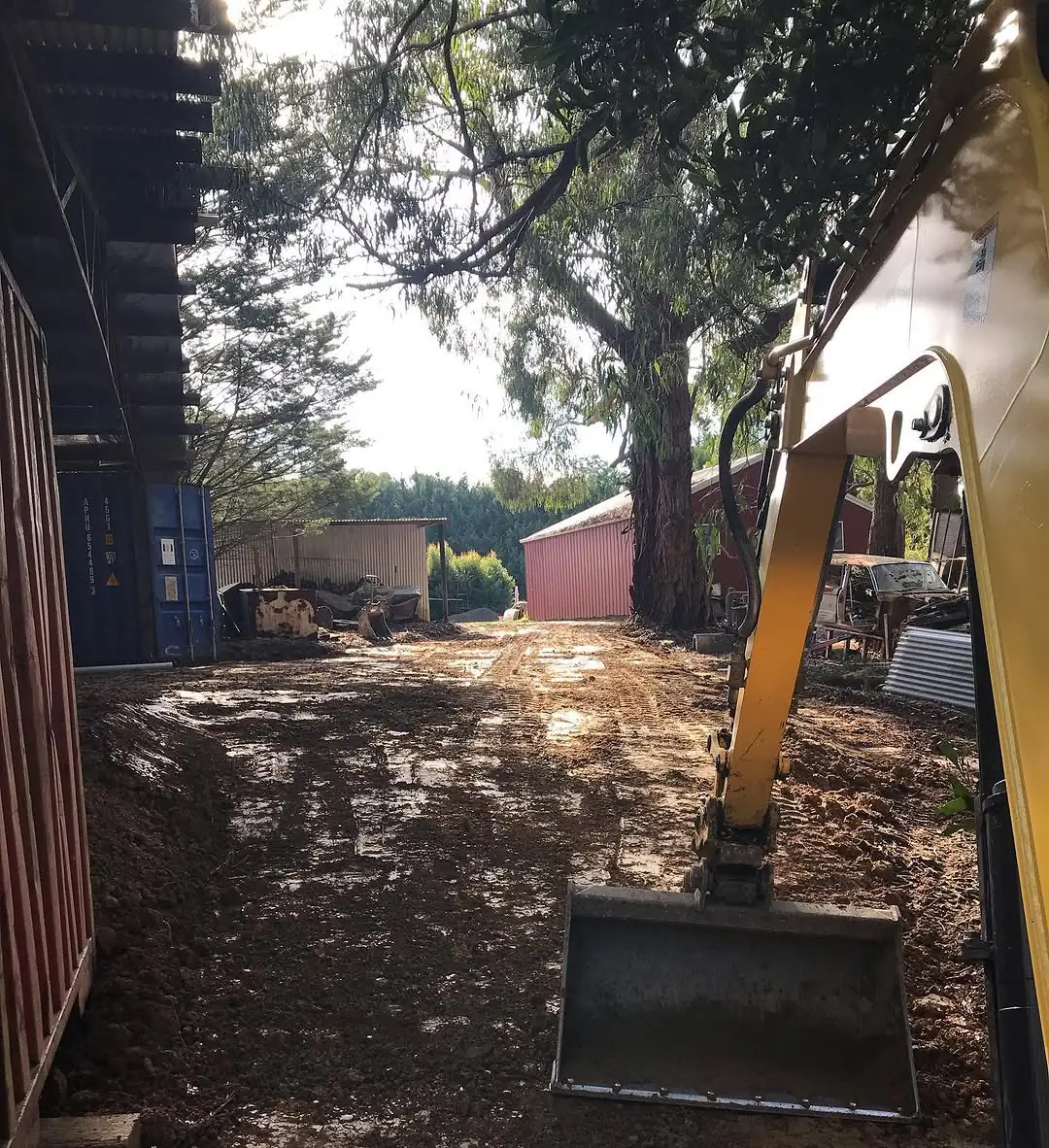

The photo is the cut stage: bare ground opened up and shaped, still wet, before anything went on top. Doing the driveway cut and the shed pad in the one visit means the machine only comes out once and the levels between the two tie in with each other.

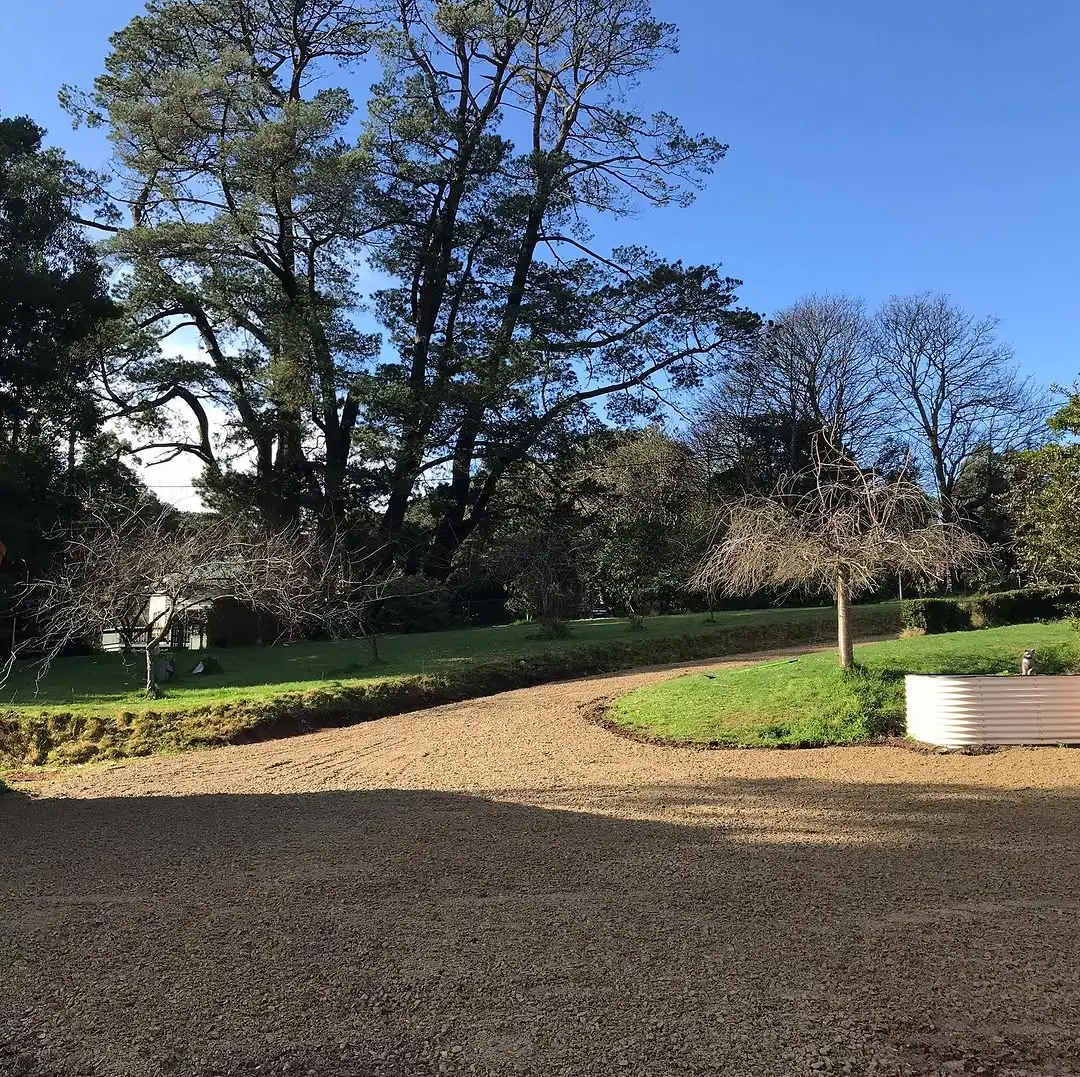

Two loads of Coldstream Class 4, a few hours’ work, and this Olinda driveway had a new surface. We rolled it the next morning.
Not every tired driveway needs digging out. If the base underneath is still sound and it is only the top that has worn thin or gone to potholes, a resurface is the cheap fix. On paper Class 4 is the economical grade of crushed rock, the one quarries sell for lower layers and fill. Spread over a driveway that already has a decent base and rolled properly, it makes a hard-wearing top for a lot less than starting again.
The fair question on a job like this is whether it beds down or washes away in heavy rain. Rolling is what beds it down. The fall decides whether it washes. Water running down a driveway with nowhere to go will carry the fines off any gravel surface, so the fall matters as much as the rock. If the base has gone, you need more than a top-up, and we will tell you so.
Longer runs and steeper gradients change the machinery, time and drainage approach needed.
Clay, rock or sandy ground all affect base preparation and compaction.
Gravel and aggregate driveways are finished on site; paved or concrete driveways need base prep coordinated with your paving or concreting contractor.
Straight answers on council crossovers, what goes under the surface, drainage falls, steep runs and what a rural driveway needs.
A driveway comes in two parts with two different sets of rules. The crossover is the section between the edge of the road and your property boundary, it sits on the road reserve, and it needs council consent before anyone touches it. What catches people out is that consent is not council taking it off your hands. The crossing is your asset. You pay to put it in and you pay to maintain it, even though it is not on your land. Everything past the boundary is yours as well, just without the permit. In Yarra Ranges, which covers most of the valley, constructing, altering or removing a vehicle crossing goes through a works in a road reserve permit. Budget a few hundred dollars for it, allow the ten business days council asks for, and expect a security bond to be attached to the approval. Fees change each July and every council sets its own, so get the current number from yours rather than off a website. Council also has a view on how the crossover gets built, because a street with concrete kerb and channel and an unmade gravel road with open culvert drains are not the same problem, and both of those exist within a few minutes of each other around here. We will tell you which one you are dealing with when we come and look. What we will not do is start on the crossover before the permit is in hand, because that mistake lands on you rather than on us.
The base, and it is the part that decides whether the driveway lasts. The order is topsoil and any soft spots out first, then the ground underneath compacted properly, then compacted crushed rock over the top, commonly around 75 to 100mm on a residential driveway and more where the ground is poor or the loads are heavier. Compaction matters more than depth. A thick layer of rock that has been tipped and raked rather than rolled is worse than a thinner one that has genuinely been compacted, because it settles unevenly and takes the surface down with it. The other thing we set at base level is the fall. Building drainage into the base is straightforward, hunting for it later in the screed is not, and a driveway with no fall in the base is a driveway that will pond. When a concrete driveway cracks early it is far more often a base that moved than concrete that was wrong. This is our part of the job, and it is why we would rather spend an extra hour on the base than have your concreter pour over something that is not ready.
Fall first, because it is the cheap one to get right. You want a minimum of about one in a hundred across the width so water runs off rather than sitting there, and it has to run somewhere legal, which means council stormwater or an approved system on your own property, not across the footpath and not onto next door. Steepness is the other half. The Australian standard for domestic driveways sets the absolute maximum at one in four, a twenty five percent grade, and one in five is the ceiling most people are happier living with. The thing that actually catches people out is not the slope, it is the change of slope. Where the grade changes by more than one in eight you need a transition of at least two metres to smooth it, and that is the difference between driving in normally and scraping the front of the car every time you come home. On a sloping block the honest answer is sometimes that the driveway wants to take a different line across the site than the obvious straight run from the road to the garage. Much better worked out before anything is dug than after.
Room for a fire truck, and it changes the whole design. The CFA access guidance starts once the run from the road to the house or the water supply is longer than 30 metres. From there the driveway surface wants to be 3.5 metres wide, with another half a metre each side clear of gate posts, shrubs and anything else, and clear overhead to 4 metres. The surface needs to be all weather with a load limit of at least 15 tonnes, which is a real constraint on a track that turns to soup in August. Past 100 metres you need somewhere for a truck to turn around, either a circle with an eight metre radius or a T or Y shape with arms of at least eight metres from the centre. Past 200 metres, if the driveway is narrower than six metres, it needs passing bays six metres wide and twenty metres long at least every 200 metres. Grade counts too, an average of no steeper than one in seven, and no more than one in eight going into and out of a dip. Plenty of existing valley driveways meet none of that and nobody is going to make you rebuild one that is already there. It bites when you are putting a new driveway in or a planning permit is involved. It is also just sensible. If a fire truck cannot get up there, neither can a delivery, a removalist or an ambulance.
It will if the water has nowhere to go but straight down it. Gravel copes with a slope better than people expect. What strips a gravel driveway is water running along the surface, picking up the fines that hold it together and leaving loose stones behind. So on a steep run the fix is shape before rock: a crossfall or a slight crown so water leaves across the width, spoon drains or cut offs that turn it off the driveway at intervals, and somewhere legal for it to end up. Compacted crushed rock holds a slope better than loose round gravel, because the angular pieces lock together once they are rolled. On the steepest pinch of some hills driveways gravel stops being the right surface at all, and a sealed or concrete strip on just that section can save the rest of the run. We will tell you if yours is one of those.
The digging is the short part. Machine time on a straightforward residential driveway is usually a day or two, and a long rural track is a few days more depending on the length, the ground and how much has to be moved. What actually sets the start date is the council permit, ten business days at Yarra Ranges on a clean application and longer if the road is an arterial and the application gets referred on. Get that in early, it is the one part of the job nobody can hurry. Sequencing matters as well. A driveway normally goes in near the end of the outside work, after the site cut, after the retaining and the stormwater, and once the garage or shed slab is in so the finished level is actually known. Put it in earlier and it gets chewed up by everything that follows. Then there is the ground. A base compacted into wet ground does not stay compacted, so late spring into summer, once the valley has dried out, is the easiest time of year to build one. If the job is not urgent, we would rather wait out a wet week than rush it.
